19. Project Development
Track the progress of your final project by answering following few questions
My final project is a smart carry-on suitcase named "SMART SUITCASE - The Follower Friend" - which will follow the traveller around automatically.
Tasks completed :
Tasks remaining :
All tasks are completed as per the plan. So, no tasks are remaining.
I am happy that everything is worked and the suitcase is able to follow the user properly. All designed parts fittled properly during the assembly. Also, all three circuits worked as per the expectations.
There are as such no questions to be resolved as far as final project is concerned. But there can be some future development in this project such as addition of IR sensors for detection of obstacles in the path of suitcase, Android app controlled lock and mode selection, GPS tracking etc. However due to limited time available for development this thing is not covered in the scope of the project.

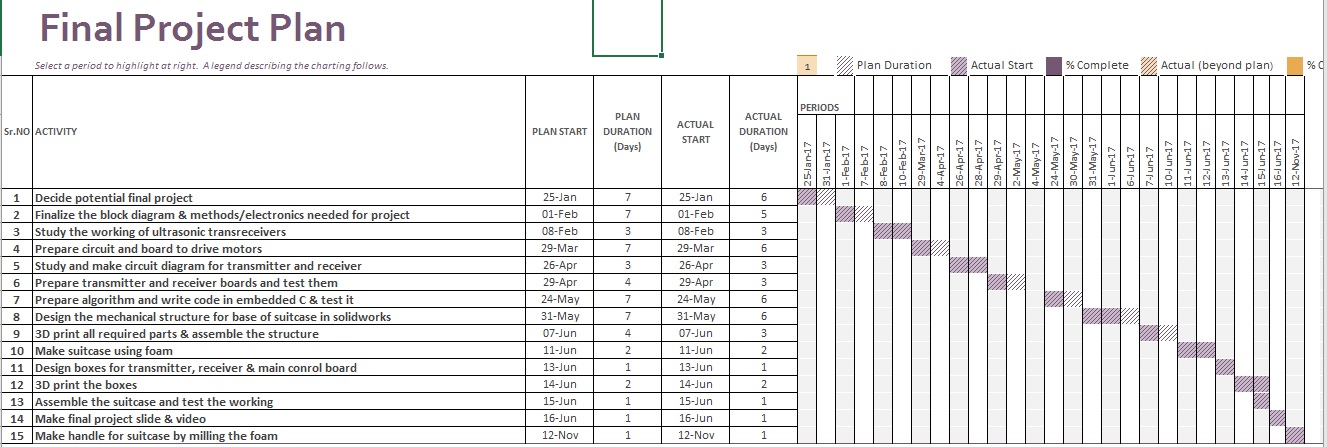

Here is the gantt chart prepared for final project.
You can download gantt chart here
Many things are learned during this course. Being an electronics engineer, CAD design,, 3D printing & scanning, molding & casting etc were new things for me.
I got a chance to learn about these processes, to make hands-on while completing assignments of all these processes.
Things/Processes I learned during this course and used in my final project are -
